The definitive guide for logistics decision-makers who are tired of vendor-speak and want to understand what these three systems actually do, and which problems each one genuinely cannot solve.
There is a conversation that happens in almost every logistics management systems comparison process, and it goes something like this.
Someone in the room says, "Don't we already have a WMS? Why do we need a YMS?" Someone else says, "Isn't this what the TMS is supposed to handle?" And then the vendor explains, at length, why their system is different from all the others, and everyone in the room nods, but nobody is quite sure they believe it.
This confusion is not ignorance. The industry relies on overlapping acronyms, and many of them refer to systems with intersecting functions, which naturally creates confusion. At the same time, vendors often broaden how they define their system’s scope, presenting it as more comprehensive than it actually is.
So let's be blunt about what this article is and what it isn't.
This isn't a neutral academic yms vs tms vs wms comparison. We built a Yard Management Solution, so we have a perspective. But we've tried to make this the most useful, most honest breakdown of these three systems available. This includes being clear about what a YMS software does not do, where a Warehouse Management Solution is the right tool, and where a transportation management system earns its keep. Our goal is to help logistics operations leaders make the right technology decisions, not to sell our product to people who don't need it.
With that said, there is a gap between what a WMS manages and what a TMS manages. It is well-defined, it is significant, and it is causing measurable operational and financial losses at thousands of facilities globally. That gap is called the yard. And most facilities are managing it with a radio, a whiteboard, and hope. For readers evaluating enterprise transport capabilities in depth, explore how a transportation management system for enterprises supports large-scale logistics operations.
The One-Paragraph Version (for the Time-pressed Executive)
A Warehouse Management Solution, or WMS, handles internal warehouse operations. This includes inventory, picking, putaway, labor allocation, and goods receipt.
A Transportation Management System, or TMS, focuses on external movement. It covers carrier selection, route planning, load building, and shipment tracking on the road.
However, neither system covers the space between the road and the warehouse. This includes the gate, the queue, the yard, and the dock doors. It also includes the 45 to 90 minutes a truck spends onsite. During this time, the WMS often has no visibility of its arrival.
This is where a Yard Management Solution becomes handy. It manages everything from the moment a truck pulls into your facility to the moment it leaves. It is not a feature of a good WMS or TMS. It is a distinct operational domain that both systems have historically ignored because it's too physical and real-time for either to handle well.
The core insight
WMS = inside the four walls
TMS = outside on the road

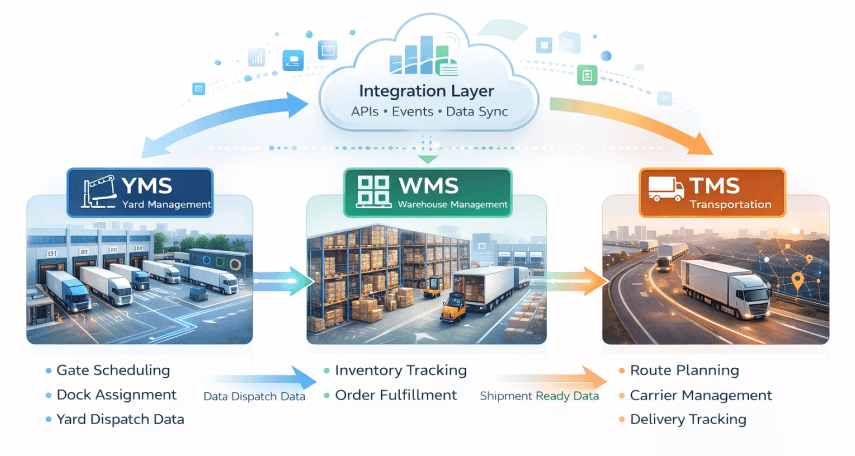

YMS = the physical interface between the two.
None of these supply chain management software types replaces the others. They serve adjacent domains with a clear handoff point at the gate.

What WMS Actually Manages?
The Warehouse Management Solution is the operational backbone of the warehouse itself. It is designed to optimize everything that happens once goods have entered the four walls and until they leave again.
The WMS Domain: What It Owns
Inventory Management
It is a core competency of the warehouse management system features. The WMS knows what you have, where it is, in what quantity, in which lot, with which expiry date, and in which bin location. It tracks every stock movement (receipts, putaway, picks, transfers, dispatch), and maintains the real-time inventory record that drives warehouse operations and feeds the ERP.
Labour Management and Task Allocation
These are the second major domain. The WMS directs warehouse operatives at a task level. It defines what to pick, in which order, and using which equipment. It also guides movement through specific paths inside the facility. In a well-implemented setup, each operative follows a planned task. The system assigns work based on efficiency logic. There is little need for on-the-spot decision-making.
Goods Receipts
This is where the warehouse management system features meet inbound logistics. Once unloading begins, the system records the received goods. It compares actual quantities with expected deliveries. It also flags variances and triggers putaway instructions.
The WMS then posts this receipt to the ERP. This supports inventory updates and accounts payable processes. On the outbound side, the distribution center management system manages dispatch and shipping. It handles picking, packing, labelling, staging, and also confirms when goods leave the facility. The WMS knows which orders are ready for which carriers and when.
WMS Vendor Market
The enterprise Warehouse Management Solution market is led by a few established platforms. These include SAP Extended Warehouse Management, Manhattan Associates WMS, Blue Yonder, Oracle WMS Cloud, and Körber. Mid-market and SMB operations rely on more flexible options. Common choices include Infor WMS and Microsoft Dynamics 365 Supply Chain, along with niche solutions. Each system has strengths in specific industries. SAP Extended Warehouse Management is widely used in discrete manufacturing and chemicals. Manhattan Associates performs strongly in retail and e-commerce. Blue Yonder is common in FMCG environments.
What a WMS Does NOT Do and Why?
Here's where most WMS system benefits: conversations get evasive. The WMS does not manage the gate. It does not manage the queue of vehicles waiting to be processed. It does not manage dock assignments. It does not manage the yard, which is the physical space between the gate and the dock where trailers are staged, assets are parked, and vehicles wait.
The reason is architectural, not a product oversight. WMS systems were designed around the concept of a bin location. It was a fixed, numbered position within the warehouse that could hold inventory. The yard is a dynamic, physical space with no fixed bin structure. A truck in Bay 7 today might be in Bay 12 tomorrow. A trailer dropped at 9 am might not be collected until 4 pm. Modelling this in a bin-location-centric architecture is awkward at best, and most WMS vendors have never invested in making it work properly.
Some WMS vendors will tell you their system has "yard management system features." What they typically mean is: their system has a yard slot module that lets you record which dock a truck has been assigned to. This is to a YMS software what a customer notes field in an invoice system is to a CRM. It is technically present, but operationally inadequate.
What is TMS in Logistics? What It Actually Manages
The Transportation Management System lives outside the warehouse, in the world of carriers, lanes, rates, and shipments in motion. If the WMS is about what's in the building, the TMS is about what's on the road.
The TMS Domain: What It Owns
Carrier Management and Rate Tendering
These two are the commercial core of the transportation management system. It maintains the carrier master, tracks contracted rates by lane and service level. It even automates the process of tendering loads to carriers and accepting or rejecting bids. For organisations with complex carrier networks with multiple contracts, multiple modes, and multiple geographies, a TMS is genuinely transformative.
Load Planning and Consolidation
These are about optimising what goes on which truck. A good freight management system software will consolidate multiple orders onto fewer vehicles when possible, match load dimensions and weight to available vehicle types, and sequence multi-drop routes for efficiency. This is computationally hard and genuinely valuable. A sophisticated TMS can reduce transport costs by 8 to 15% through consolidation and routing improvements alone.
Shipment Tracking and Visibility
Carriers provide real-time GPS or milestone updates; the transportation management system aggregates these into a single view of all in-transit shipments, enables exception alerting when deliveries are late, and provides the customer-facing tracking portals that shippers and retailers now expect as standard.
Freight Audit and Payment
These aspects cover the financial loop. The TMS software benefits are clear here: it reconciles carrier invoices against contracted rates and shipment records, flags discrepancies, and processes freight payments. In large organisations, freight audit alone can pay for the TMS.
If you're assessing core capabilities, our transportation management system offers the latest features and extensive use cases.
TMS Vendor Market
The enterprise transportation management system market includes SAP Transportation Management, Oracle Transportation Management, and Blue Yonder TMS. It also includes MercuryGate and C.H. Robinson's Navisphere.
Navisphere sits between TMS and managed logistics services. It blends execution with external carrier coordination. Visibility platforms like project44, FourKites, and Shippeo are often seen as TMS alternatives, but that framing is not precise. These tools focus more on tracking and intelligence, working alongside a TMS rather than replacing it.
What a TMS Does NOT Do and Why?
The transportation management system clock stops at the facility gate. Once a carrier vehicle reaches the facility, the TMS role is largely complete. It has already selected the carrier and planned the load. In many cases, it also confirms arrival through real-time updates. After that point, responsibility moves beyond the TMS.
This is another architectural decision, not an oversight. TMS systems are built around the concept of a shipment. So the job is to move a discrete unit of freight from origin to destination, tracked through a booking reference. The arrival at a facility is a shipment event (status: arrived). What happens to the truck, the driver, and the cargo during the time spent at the facility is not modelled as a shipment event sequence. It's a physical operations workflow, and TMS systems are not physical operations systems.
The gap shows up clearly in driver communication. A TMS tracks expected arrivals and live GPS movement. Once the truck is on-site, that visibility stops. The system cannot guide the driver to a dock. It cannot alert the warehouse team about arrival. It also cannot trigger a goods receipt based on gate entry. Most workflows still depend on paperwork signals. All of those handoffs happen manually, typically through a guard with a radio.
The Gap: Everything Between the Road and the Warehouse

We've now established what the WMS does and what the TMS does. Let's be precise about what neither supply chain optimization tool manages.
The Missing Layer
This refers to the set of operational events and decisions that take place from the moment a vehicle reaches the facility gate to the point it exits. It also includes the supporting processes, such as appointment booking, carrier pre-registration, and compliance validation, which prepare the vehicle for efficient handling even before it arrives.
Here is what actually happens at a typical facility without yard operations software.
- A truck arrives at the gate, and the guard has a list of expected appointments. It probably includes a spreadsheet or a printout from the WMS or TMS that someone updated earlier in the day.
- The driver presents a paper delivery note or gives a reference number verbally. The guard looks up the reference, verifies the plate (or doesn't), confirms the documentation is in order (or mostly in order), and either waves the truck through or asks it to wait.
- The truck enters the yard. The guard radios or calls the yard manager to say Truck X is here. The yard manager checks the dock schedule and either assigns a dock immediately or tells the truck to park and wait.
- The driver parks somewhere in the yard. Sometimes they're told where, but often they're told to wait, and someone will find them.
- Then, 5 minutes later, 20 minutes later, sometimes much longer, the yard manager has identified an available dock. He calls or radios the guard, who then goes to find the driver, who then needs to manoeuvre a heavy vehicle from wherever they parked to a specific dock door.
- The loading or unloading happens. When it's done, the warehouse supervisor tells someone it's done. The driver is released, they go back to the gate, and the guard records their departure time.
- Somewhere in this sequence, 45 to 90 minutes have passed. The WMS was involved for approximately 15 minutes (the goods receipt itself). The TMS tracks arrival and will record departure.
- The remaining 30 to 75 minutes happened in a communication and coordination gap that neither system sees, measures, or manages.
The specific problems this gap creates
Invisible Queue
Without a digital gate or queue system, real-time visibility breaks down. Teams cannot see how many vehicles are waiting. They also cannot track individual wait times or estimate clearance. Decisions rely on partial information because yard managers work with limited context. Carriers lack updates on delays, and SLA breaches build up without clear visibility.
No-show and Walk-in Disruptions
A transportation management system schedules carriers against planned loads. That information does not always reach the driver accurately. Drivers may arrive at the wrong time or gate. Some arrive without the required documents. Without a pre-registration layer before gate entry, each arrival introduces uncertainty.
Dock Scheduling in the dark
The warehouse management system features include knowing that dock doors exist as receiving or dispatch locations. But it doesn't manage dock availability in real time. For instance, it won't know that Dock 4 is still occupied by a truck that was supposed to be done 20 minutes ago, or that Dock 7 has been taken offline for maintenance. Dock assignment happens manually, with all the coordination overhead that implies.
Weight and Compliance Gaps
Weighbridge capture happens at the gate. Document verification happens at the gate. Both feed into the Warehouse Management Solution (for goods receipt accuracy) and the ERP (for compliance and invoice matching). But without an integrated gate management layer, neither happens automatically. Both are manual processes prone to errors, omissions, and post-hoc reconciliation.
No Cross-system Event Flow
The fleet and warehouse management software needs to know a truck has arrived before it can allocate dock resources and labour. The ERP needs to know when goods have been received to post the goods receipt and accrue the liability. The transportation management system needs a confirmed departure to close the delivery. In a gapless world, these events flow automatically from the physical gate activity. In the real world, they're often entered manually into each system by different people hours after the fact.
For a deeper look at solving operational inefficiencies, read about yard management system efficiency and optimization in high-volume facilities.

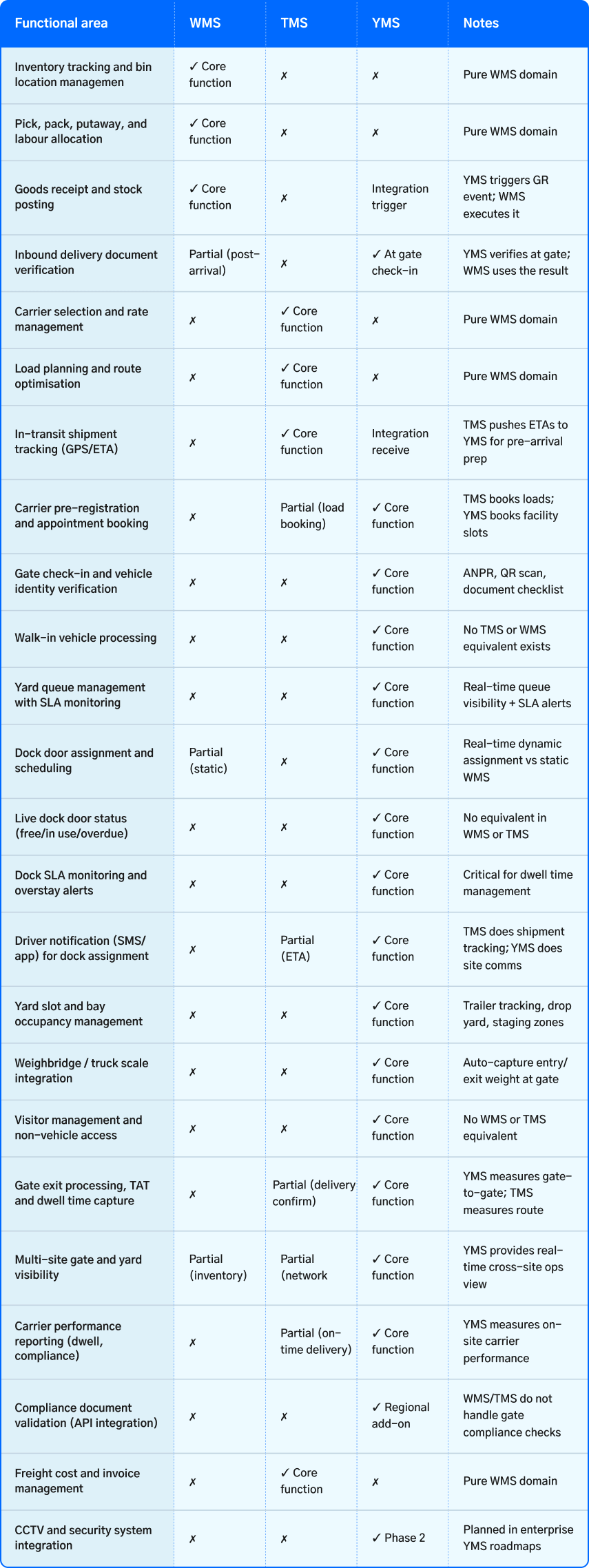

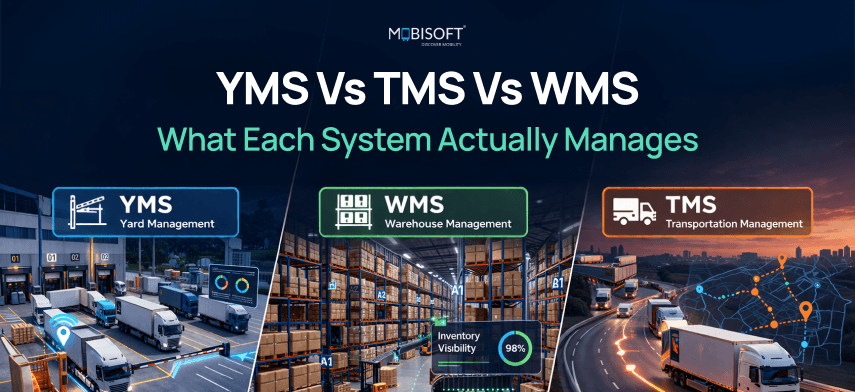

WMS vs TMS vs YMS: The Definitive Comparison
Here is every major functional area in logistics operations, and which system owns it. This table is designed to be the clearest summary of this comparison available anywhere. We've been deliberately specific about "YMS + WMS integration" and "TMS + YMS integration", where the capability genuinely requires both systems working together.

How the Three Systems Should Work Together

Once the roles of WMS, TMS, and YMS are clearly understood, the TMS WMS integration benefits become easier to follow. Each system operates in its own domain, yet they depend on timely event exchange to stay aligned.
These systems should pass events to one another as operations progress. They should not duplicate tasks or recreate the same data. Gaps between them should not exist. At the same time, teams should not have to manually connect each step during handoffs.
With that in place, the flow becomes structured and predictable. What follows is a typical end-to-end workflow for an inbound delivery across all three end-to-end supply chain software solutions.
The Ideal Inbound Flow
- The transportation management system selects a carrier and books a load. It knows the delivery is expected at Facility A on Tuesday between 09:00 and 11:00. It pushes this information of the carrier, vehicle, and expected arrival window to the yard operations software via API. The YMS creates a draft appointment record.
- The carrier dispatcher receives a booking link from the YMS and completes the pre-registration. This confirms the driver's name, vehicle registration, transport document reference, and cargo details. This takes 3 minutes on a mobile phone. The YMS generates a gate pass (QR code) and sends it to the driver's phone via SMS.
- The carrier's vehicle approaches the facility. The TMS is tracking the GPS position and pushes a predicted arrival time to the YMS. The YMS sends a 30-minute reminder notification to the guard.
- The driver arrives at the gate. The ANPR camera reads the plate. The Yard Management Solution matches it to the pre-registered appointment in under 2 seconds and pre-populates the check-in form. The guard verifies the document checklist (pre-validated for the compliance reference if the relevant API is configured) and taps Confirm. Check-in is complete in 90 seconds. The Warehouse Management Solution receives a "vehicle arrived" event from the YMS and begins allocating dock labour.
- The yard manager sees the vehicle in their live dashboard. Based on the cargo type and dock availability, the yard operations software is monitoring all dock doors in real time, so they assign Dock 7. The driver receives an SMS, "Report to Dock 7." The distribution center management system receives a "dock assigned" event from the YMS and confirms the putaway zone for the cargo.
- The warehouse team completes the unloading. The warehouse supervisor marks the dock as released in the YMS. The YMS immediately pushes a GR trigger event to the Warehouse Management Solution (which posts the goods receipt and updates inventory) and to the ERP (which posts the accounting entry and enables invoice matching). The transportation management system receives a "delivery confirmed" event and closes the shipment.
- The driver departs the gate, and the guard completes the exit check in the YMS. The weighbridge captures the exit weight automatically. The YMS records the final dwell time, calculates the TAT, flags any SLA breach, and closes the appointment record.
- From a process standpoint, no human entered data into more than one system. No event was manually bridged between systems. The Warehouse Management Solution, transportation management system, and Yard Management Solution each did their job within their domain and communicated the handoff events automatically.
This is how it should work. At most facilities, it doesn't work like this yet.
Where Integration Breaks Down in Practice
The most common failure mode is the WMS-YMS handoff. Many warehouse management system implementations predate the concept of a YMS, and the WMS was configured with the assumption that dock management is someone's manual job. Adding a Yard Management Solution doesn't automatically create the event flows; it requires API integration work, field mapping between the two systems, and decisions about which system is the source of truth for dock assignment (it should be the YMS, as it is a common point of contention with WMS vendors).
The TMS-YMS handoff is less contentious but still frequently absent. Transportation management systems that push carrier booking details to a YMS for pre-registration are in the minority. More commonly, the carrier gets an email from the TMS with booking details and is expected to separately register in the facility's carrier portal. The two systems never speak to each other, and the facility loses the pre-fill benefits that make the booking process fast for carriers.
The ERP connection is the integration that generates the most financial value and the most organisational resistance. Specifically, the automatic GR posting triggered by the YMS dock release. Finance teams are understandably nervous about an operational system (the YMS) triggering accounting entries in the ERP. The risk management conversation (what happens if the YMS triggers a GR for a delivery that actually had a quantity variance?) needs to be had explicitly, and the variance detection and exception workflow needs to be configured properly before this integration goes live.
Common misconceptions: the questions every buyer gets wrong
"Our WMS already has yard management, do we really need a separate YMS?"
This is the most common objection, and it deserves a direct answer.
Every major Warehouse Management Solution vendor has a module they call yard management. What it typically does: allows you to record which dock a vehicle has been assigned to, and mark that dock as occupied or free. Some systems add a basic appointment calendar. The better ones add a simple queue list.
What these WMS yard modules almost never do: ANPR/plate recognition integration, real-time live dock status with SLA timers, walk-in registration workflow, yard slot map with dynamic bay assignment, driver SMS notifications, cross-site visibility, weighbridge hardware integration, compliance document validation, or carrier-facing self-service booking portal.
The test: open your WMS yard module and ask yourself whether a guard could process 60 vehicles in a shift using it without picking up the radio once. If the answer is no, which it almost always is, you don't have a yard management system. You have a dock assignment log.
"Can't the TMS handle carrier pre-registration and scheduling?"
The transportation management system manages load bookings. Load bookings and facility appointments are related but different things.
A load booking says: Carrier X will pick up Load 4521 from Facility A on Tuesday. A facility appointment says: Vehicle ABC-1234 driven by John Smith will arrive at Gate 2 between 09:00 and 09:30 on Tuesday for the delivery of PO 45001 and should be directed to the refrigerated dock zone.
The difference is not subtle. The TMS booking is commercial and logistical. The facility appointment is operational and physical. It needs driver details (the TMS often only has carrier details). It needs a vehicle registration for ANPR matching (the TMS doesn't care which specific truck carries the load). It needs a time slot within the facility's available capacity (the TMS only knows the delivery day, not the 30-minute window). It generates a gate pass and triggers a notification to the driver, neither of which is one of the transportation management system features.
Some advanced TMS implementations do push load booking details to a Yard Management Solution for pre-registration completion. This is an integration, not a replacement. The TMS is still only doing the commercial booking side; the facility slot management and driver-facing communication happen in the YMS.
"We have a visibility platform. Does that replace a YMS?"
Visibility platforms like project44, FourKites, and Shippeo track shipments in transit. They're very good at what they do: real-time GPS, ETA predictions, milestone updates, exception alerting for late deliveries.
Their visibility ends at the facility boundary. They know when a truck is 20 minutes away. They don't know when it arrived, how long it waited at the gate, which dock it was assigned to, how long the operation took, or when it left. This is not a gap in their product, but a deliberate scope decision. They optimize the in-transit leg, not the facility leg.
A Yard Management Solution picks up exactly where a visibility platform's data ends: from the moment the truck is on site to the moment it leaves. On integration, they provide end-to-end supply chain software solutions across the full delivery journey.
"Do smaller facilities need a YMS, or is this enterprise software?"
The honest answer: any facility processing more than 20 to 25 vehicles per day benefits meaningfully from digital gate management. Below that volume, the coordination overhead is manageable without software. Above it, the manual process starts showing cracks. Guards, for instance, spend more time on administration than security, dwell times creep up, and walk-in rates stay high because the booking process is too cumbersome.
Modern YMS software platforms built on cloud SaaS architecture (as opposed to the traditional on-premise implementations that dominated a decade ago) are deployable in days, not months, and priced on a per-site or per-user basis that makes them accessible to mid-tier logistics software for enterprises. The days when a YMS was a multi-million-pound enterprise implementation with 18-month timelines are not entirely gone, but the market has moved significantly.
How to Decide Which System You Actually Need Right Now
The decision framework is straightforward if you're honest about where your operation currently has the most unmanaged complexity.
You need a WMS if:
- Your inventory accuracy is below 98%, and you can't reliably find stock within the warehouse
- Your pick rate is significantly below industry benchmarks for your category
- You are running on a basic stock system (QuickBooks inventory, spreadsheets, basic ERP modules) with no real warehouse automation software capability.
- You have multiple product types, batch/lot requirements, or FIFO/FEFO rules that your current system can't enforce
- You're scaling to a second warehouse and need a custom warehouse management system development that can manage multiple sites with shared inventory.
You need a TMS if:
- You're managing a complex multi-carrier, multi-mode transport network with significant freight spend (typically >$2M annually to justify a full TMS)
- You have no visibility of in-transit shipments and are regularly surprised by late deliveries
- Your freight audit process is manual, and you suspect you're overpaying carriers due to invoice errors
- You're running multi-stop routes or managing parcel consolidation at scale
- You have significant cross-border freight with complex customs documentation and mode changes
You need a YMS if:
- Your average truck dwell time is above 40 minutes, or above 35 minutes for the cold chain
- Your walk-in (unscheduled arrival) rate is above 10%
- Your guards spend significant time on radio coordination or manual queue management.
- You have frequent dock scheduling conflicts. Waiting trucks because the docks are occupied, or they are sitting empty because the yard manager doesn't know a truck is ready
- You have multiple facilities and no cross-site visibility of gate or dock operations.
- You are paying detention charges and can't easily report which vehicles caused them.
- Your WMS and TMS don't currently talk to each other at the point of vehicle arrival.
The most important question
Check if your Warehouse Management Solution and transportation management system are both well-implemented, and you are still experiencing gate queues, dock scheduling confusion, high dwell times, and manual coordination overhead. If so, improving your WMS or TMS further will not fix it. You will need a Yard Management Solution because the root cause is in the domain that neither WMS nor TMS manages.
What to Look for in a YMS Beyond the Basics
If you've decided that YMS software is the right next investment, the market has a range of options from point solutions to enterprise platforms. Here are the dimensions that separate genuinely capable systems from good-looking demos.
Real-time vs near-real-time
The live dashboard, dock status grid, and queue list should update continuously, not on a 5-minute polling cycle. In a busy yard operations software environment, a lot can change in 5 minutes. A dock that showed as available 4 minutes ago may be mid-assignment. A queue that looked manageable may now have an SLA breach in it. The difference between a true real-time system and a near-real-time one shows up acutely during peak periods.
Hardware integrations: ANPR, weighbridge, boom barrier
The distinction that matters here is hardware-agnostic integration versus single-vendor lock-in. Your facility may have Hikvision cameras today and Axis cameras after the next upgrade. The Yard Management Solution should accept plate reads from any ANPR system via a standard REST webhook, not require you to use a specific camera brand. The same principle applies to weighbridges. The system should support TCP/IP and RS-232 serial connections and work with any scale manufacturer.
Multi-site global architecture from day one
Many YMS software products were built for single-facility deployment and bolted on multi-site capability later. The seams show: the cross-site dashboard is a summary report rather than a live operational view, timezone support is incomplete, and per-site configuration (SLA thresholds, document labels, locale settings) is clunky. If you operate or plan to operate multiple facilities across regions or countries, this architectural distinction matters enormously.
Carrier self-service that carriers actually use
A carrier booking portal is only as valuable as its adoption rate. The test of a good carrier portal is: can a small owner-operator complete a booking in under 3 minutes on a mobile phone, without creating an account, and receive a QR gate pass on their WhatsApp? If the answer is no, if the portal requires account registration, is desktop-only, or takes 8 steps, your walk-in rate will not improve regardless of how good the back-end system is.
WMS and ERP integration that handles the GR workflow
Basic WMS system benefits integration is easy to demo. Simply look at this webhook as it sends an event when a truck checks in. What's harder, and more valuable, is the full WMS and TMS integration that includes ASN inbound enrichment (the WMS pre-populates the appointment with cargo line details when the ASN is received), dock recommendation (the WMS suggests which dock based on putaway zone), and GR trigger (the YMS fires the goods receipt posting event when the dock is released). Ask specifically about all three layers of this integration, not just the check-in webhook.
Common Questions on WMS, TMS, and YMS
What is the difference between a WMS and a YMS?
A Warehouse Management Solution, or WMS, handles operations within the warehouse, including inventory control, picking, putaway, goods receipt, and dispatch. A Yard Management Solution, or YMS, focuses on activities at the facility perimeter and yard, such as vehicle check-in, dock allocation, queue handling, carrier pre-registration, dwell time tracking, and gate exit coordination. The WMS begins tracking activity when goods arrive at the dock. A YMS, on the other hand, covers the process from the moment a vehicle reaches the facility gate.
What is the difference between a TMS and a YMS?
A Transportation Management System, or TMS, handles carrier selection, load planning, route optimisation, in-transit tracking, and freight audit. It operates primarily on the road outside the facility. A Yard Management Solution manages activities within the facility boundary, covering the process from gate arrival through to gate exit. The TMS completes its active role once the carrier reaches the site, after which the YMS takes over operational control. Both systems work in coordination, with the transportation management system sending carrier and load details to the YMS for pre-registration. The YMS then returns departure confirmations to close the delivery cycle.
Can a WMS replace a YMS?
No, and this is one costly misconception in logistics management systems comparison. WMS vendors often include basic dock scheduling functionality, but this is not a YMS. A WMS dock module typically allows you to record which dock a vehicle has been assigned to and mark it as occupied. A Yard Management Solution provides real-time queue visibility, ANPR-integrated gate check-in, driver SMS notification, live dock SLA monitoring, weighbridge integration, yard slot management, and a carrier-facing booking portal. These yard management system features do not exist in WMS systems and cannot be replicated by configuring a WMS differently.
What does YMS stand for?
YMS stands for Yard Management System. It is also referred to as a Yard Management Solution, and in some regions, a Gate Management System or GMS. The terms are largely interchangeable in practice. However, Yard Management System remains the more widely used and recognised term, particularly across North America and Europe.
Do I need all three WMS, TMS, and YMS?
Not necessarily at the same time, and not necessarily at the same scale of implementation. A small logistics operation may not have enough freight spend to justify a full transportation management system. A single-site facility with a simple product range may manage adequately with a basic Warehouse Management Solution. The question is where your operational problems are concentrated. If your inventory accuracy is strong, your carrier relationships are well-managed, but your gate and dock operations are chaotic, you need a YMS. You need one now and can defer the other investments. If your in-transit visibility is the primary problem, a TMS or visibility platform addresses that specifically. To make the correct decision, refer to this guide on how to choose the right transportation management system for structured evaluation criteria.
How does YMS integrate with SAP?
YMS software integration with SAP, including SAP Extended Warehouse Management, SAP Transportation Management, and SAP S/4HANA, typically relies on REST APIs using standard JSON event payloads. Key integration points include SAP pushing ASN and PO data to the YMS when shipments are planned (inbound from SAP), the YMS pushing dock assigned and dock released events to SAP (outbound to SAP), and SAP posting the Goods Receipt (Material Document) when triggered by the YMS dock release. Field mapping between SAP's data model and the YMS data model requires configuration, but is well-understood for the major SAP YMS integrations. Specific SAP BAPI and IDoc compatibility varies by YMS vendor.
The Bottom Line
The logistics software for enterprises market has spent years encouraging buyers to think in terms of which system to buy. WMS or TMS? WMS or ERP? WMS or YMS?
The more useful question is: what problem are you actually trying to solve, and which system's domain does that problem live in?
If your problem is inventory accuracy and warehouse productivity, that's a Warehouse Management Solution problem.
If your problem is carrier costs, transport network visibility, and freight audit, that's a transportation management system problem.
Gate queues, dock scheduling confusion, high dwell times, and unplanned walk-ins all point to the same issue. The 45 to 90 minutes of manual coordination between road and warehouse often go unmeasured. This is a yard management problem. Which means it's a domain that your Warehouse Management Solution cannot solve, your transportation management system cannot solve, and that has historically been managed by a guard with a radio and a whiteboard.
That's changing. The YMS software market has matured to the point where cloud-based, API-integrated Yard Management Solution is accessible to mid-tier logistics software for enterprises, not just tier-one global 3PLs. The TMS WMS integration benefits are well-established. The ROI case is quantifiable, and it includes dwell time reduction, detention charge recovery, and dock utilisation improvement.
The gap is well-defined. The question is how long you're comfortable leaving it unmanaged. If you're planning implementation, partner with a logistics software development company to build scalable, integrated supply chain solutions.
Methodology note
This guide was written by the YardOS Operations Research team based on direct experience building and deploying a Yard Management System, customer data from YardOS deployments, and analysis of the major WMS, TMS, and YMS vendors' published feature documentation and integration specifications. Where specific vendor capabilities are described, they reflect publicly available documentation as of Q1 2026. Vendor capabilities evolve; verify current functionality directly with vendors when making procurement decisions.
YMS Vendor Evaluation Checklist
40 Questions to Ask Any Yard Management System Vendor
Use this checklist to evaluate any YMS vendor, including YardOS. Every question is designed to surface whether a vendor's capability is production-ready or demo-only.
How To Use This Checklist
Score each question on a 0–3 scale: 0 = vendor cannot demonstrate this, 1 = partial / roadmap item, 2 = available but requires configuration, 3 = production-ready out of the box. Total score out of 120. A score above 90 indicates a mature, capable YMS. A score below 60 indicates significant gaps.
For questions marked (★ Critical), a score of 0 is disqualifying for a production deployment. Do not proceed with a vendor who cannot demonstrate these capabilities.

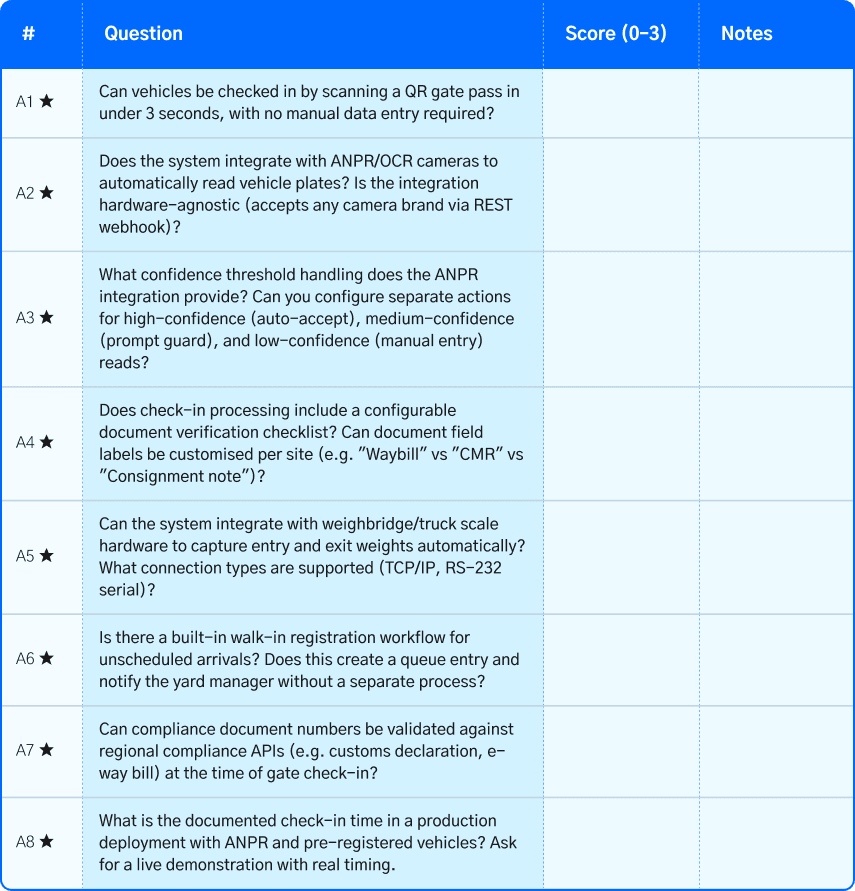

Section A: Gate & check-in capabilities (8 questions)

Section B: Queue management & yard operations (7 questions)

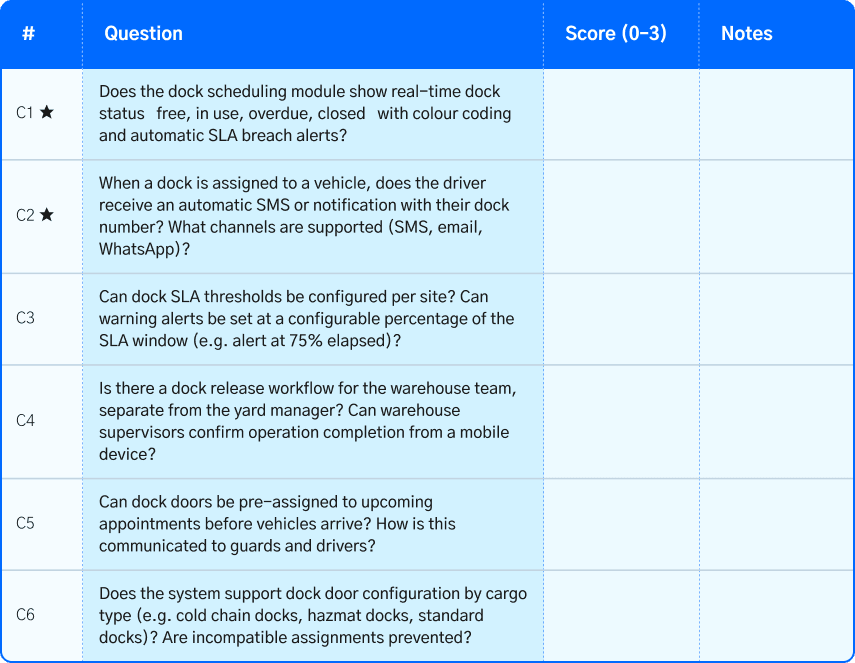

Section C: Dock scheduling & SLA management (6 questions)

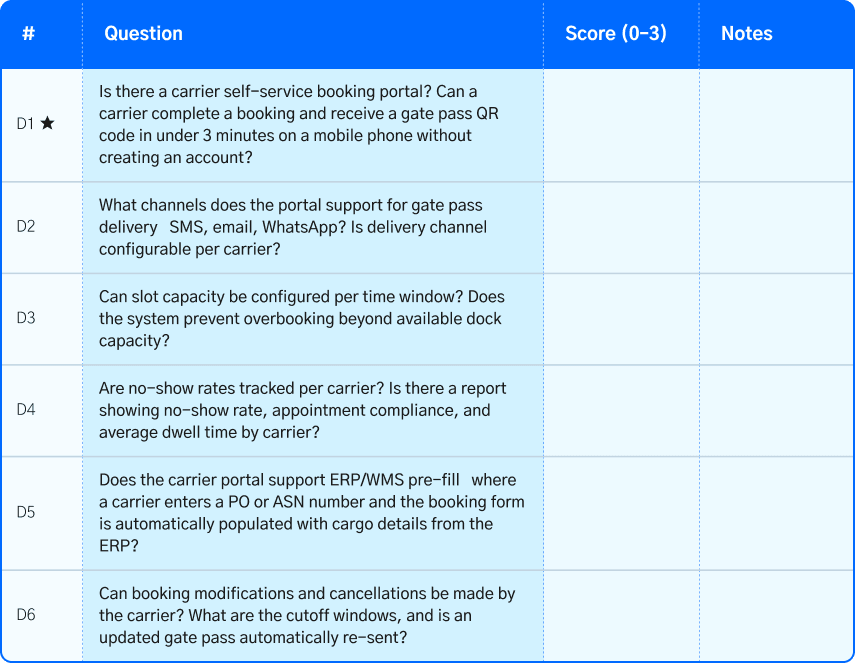

Section D: Appointment booking & carrier portal (6 questions)

Section E: System integrations (7 questions)

Section F: Multi-site & global operations (4 questions)

Section G: Reporting & analytics (5 questions)

Section H: Security, access control & compliance (4 questions)

Section I: Deployment, onboarding & support (3 questions)

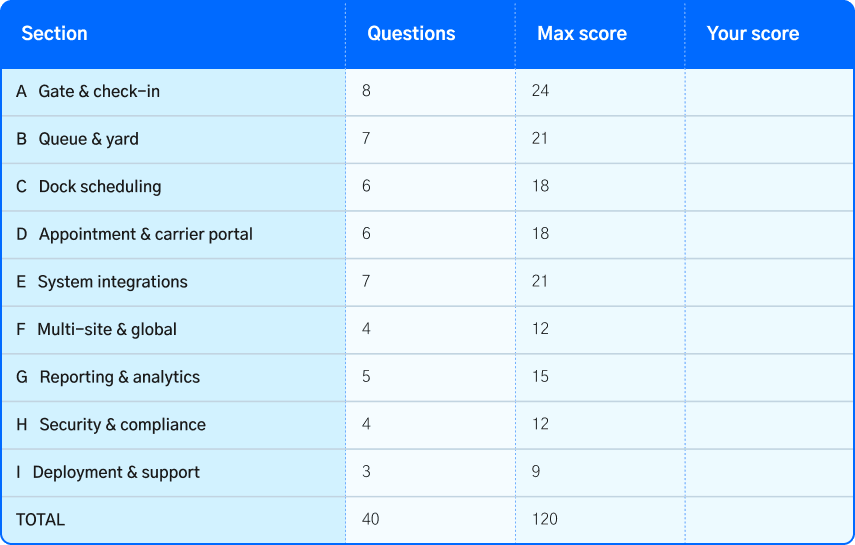

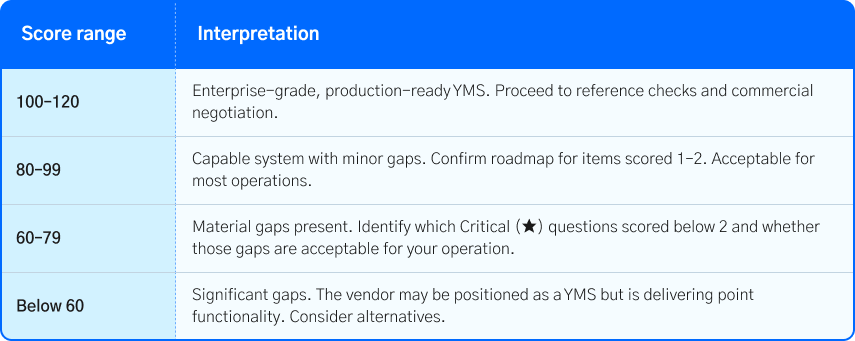

Scoring Summary

Important note
This checklist was created by YardOS. We have scored ourselves against every question all 40 items. If you'd like to see our self-assessment alongside a live demonstration, contact us, and we'll walk through it with you. We welcome the same scrutiny we're asking you to apply to every vendor you evaluate.

April 13, 2026
